How Long Does App Development Take, Start to Finish?

· Practical guidance for Singapore SMEs

Hands arranging sprint planning sticky notes

Most mobile apps take 3 to 12 months to build, depending on scope: simple apps run 2 to 3 months, medium-complexity apps run 4 to 7 months, and complex, multi-role apps run 8 to 12+ months. Ranges shift with platform choice, integrations, and how many features you’re trying to launch on day one, but the number that actually controls your finish date is the critical path, the sequence of dependent tasks that can’t be skipped or parallelized.

A typical project moves through six phases, and industry data puts the full cycle at roughly 20 to 40 weeks from discovery to launch, with planning at 2 to 3 weeks, design at 2 to 4 weeks, development at 3 to 6 months, testing at 3 to 6 weeks, deployment at 1 to 2 weeks, and post-launch stabilization at 2 to 4 weeks.

Before you commit to a schedule, answer two questions: How many distinct user roles does the app need (customer only, or customer plus staff plus admin)? And how many outside systems does it have to talk to (payment gateways, inventory software, CRMs)? Your answers place you in one of three complexity bands covered next.

Key Takeaways

App development timelines are controlled by the critical path, not total feature count, so schedule risk comes from dependent tasks and integrations, not from how long your feature list looks.

Point Details
Match complexity to timeline Simple apps run 2 to 3 months, medium apps 4 to 7 months, complex apps 8 to 12+ months.
Discovery sets the pace A clear, prioritized feature list and MVP definition upfront prevents the rework that stretches development later.
Protect the critical path Map dependent tasks early and apply a recovery playbook immediately when any milestone slips.
Don’t compress testing Cut scope to save time before cutting QA, since skipped testing resurfaces as post-launch emergencies.
Consider Flowlab’s fit review Flowlab’s complimentary app fit review gives a rough timeline, cost band, and recommended build approach before you commit.

Table of Contents

App Development Timeline by Complexity: Simple, Medium, Complex

Complexity isn’t about how the app looks. It’s about how many decisions, data sources, and user roles it has to juggle at once. A single-purpose booking app with no login screen behaves nothing like a multi-vendor marketplace, even if both fit on a phone screen.

Simple apps solve one problem for one type of user. Think a digital menu, a basic loyalty punch card, or a static event schedule. There’s little to no backend logic, often no user accounts, and minimal data storage.

  • Calendar range: 2 to 3 months
  • Typical features: one core function, static or lightly dynamic content, no third-party integrations
  • Example apps: appointment reminder tool, single-location queue display, internal price lookup app

Medium apps add user accounts, some form of payment or data collection, and at least one meaningful integration. This is where most SME operational tools land.

  • Calendar range: 4 to 7 months
  • Typical features: login and profiles, one or two API integrations (payment, SMS, or maps), a basic admin dashboard
  • Example apps: appointment booking with payments, staff attendance tracker with reporting, lead capture app tied to a CRM

Complex apps carry multiple user roles, real-time features, and several integrations that all need to stay in sync. Enterprise-grade queue systems, multi-branch POS platforms, and marketplace apps sit here.

  • Calendar range: 8 to 12+ months
  • Typical features: multi-role permissions (customer, staff, admin), real-time syncing, several third-party APIs, custom reporting

Industry guides consistently group projects into these same three buckets, which tells you the pattern holds across most SME-scale builds, not just one vendor’s experience.

Phases can overlap once requirements are locked. Design can start while discovery wraps up its final sign-off, and backend development can begin before every screen is finalized. What can’t overlap is testing before development finishes the feature it’s testing, or deployment before app-store review clears. Trying to force that overlap is the single most common cause of a blown launch date.

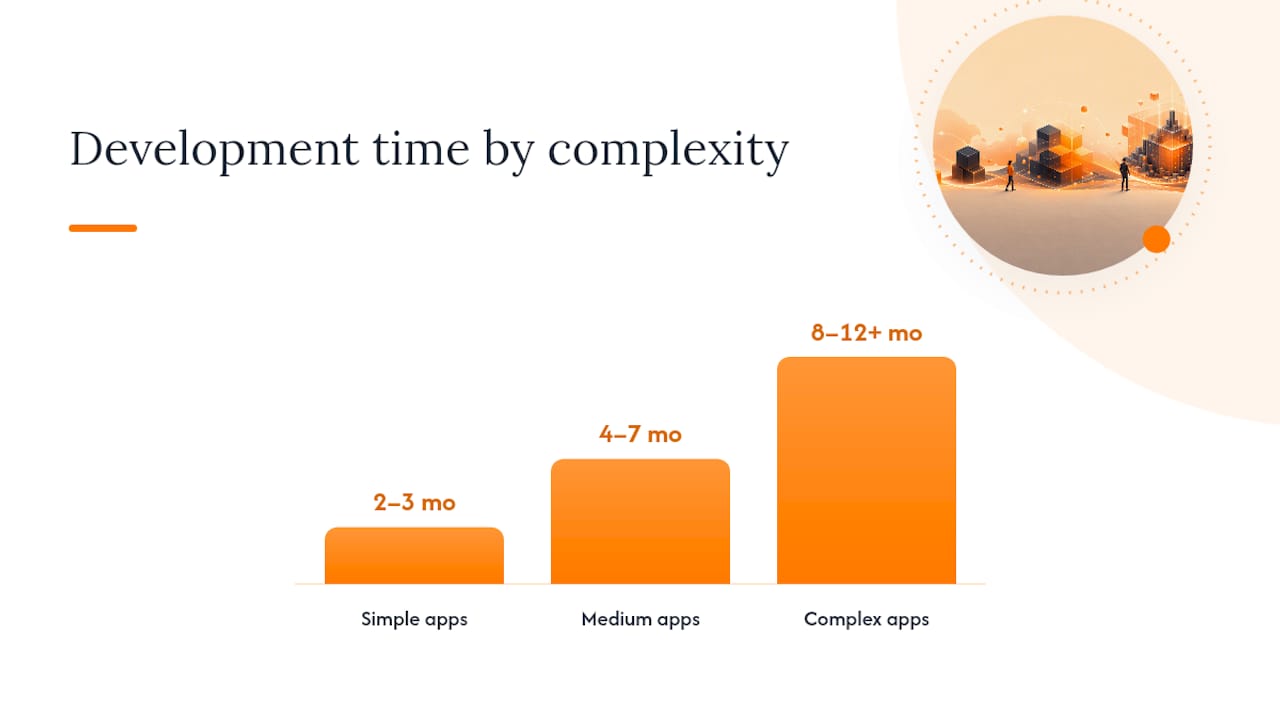

App Development Timeline by Complexity: Simple, Medium, Complex — overview diagram

App Development Phases: What Happens and How Long Each Takes

Each phase produces a specific deliverable that marks it “done.” Vague endings (“design is mostly finished”) are where schedules quietly slip by weeks. Here’s what each phase should hand off before the next one starts.

Discovery and planning (1 to 4 weeks)

This phase turns a business problem into a documented plan. It includes stakeholder interviews, a requirements document, and a prioritized feature list that separates “must-have for launch” from “nice to have later.”

  1. Stakeholder interviews and workflow mapping (2 to 5 days)
  2. Requirements document draft and review (3 to 7 days)
  3. Prioritized feature list and MVP definition, sign-off (2 to 5 days)

Projects with a clear existing process (you know exactly what the app needs to replace) land at the low end. Projects where the team is still debating “what should this even do” stretch toward four weeks, and that time is worth spending. A structured discovery deliverable, one that includes a feature list, a vendor risk register, and an MVP definition, cuts a meaningful chunk of the uncertainty out of everything downstream.

Design (2 to 6 weeks)

Design converts the requirements into wireframes, then interactive prototypes, then a signed-off visual system. The duration depends almost entirely on iteration count: a two-round review cycle finishes in two weeks, while a five-round cycle with multiple stakeholders can run past six.

  • Wireframes and user flow diagrams (1 to 2 weeks)
  • Interactive prototype and stakeholder review (1 to 2 weeks)
  • Final design sign-off and asset handoff (3 to 7 days)

Design sign-off should function as a hard milestone, meaning zero-duration and gate-based, not a task with its own duration. Confusing milestones with tasks is one of the most common ways plans quietly lose a week: the milestone gets budgeted like a task, and the actual gating decision gets skipped.

Development (3 to 6 months)

This is where most of the calendar time lives, and it’s where feature count drives duration most directly. A single-role app with no integrations might clear core development in 6 to 8 weeks. Add payment processing, a second user role, and an API connection to inventory software, and you’re looking at 3 to 5 months. Add real-time syncing across multiple locations and you’re in 5 to 6 month territory.

Development typically runs in sprints of one to two weeks, with front-end and back-end work happening in parallel once API contracts are agreed. Integration points, the moments where your app has to talk to a payment gateway or a third-party system, are usually the slowest part, because you’re dependent on someone else’s documentation and someone else’s support queue.

Pro Tip: Ask any third-party API vendor for their actual integration turnaround time in writing before you build it into your schedule. “Should take a few days” from a sales call and “took three weeks because their sandbox environment was broken” from an engineer are two very different numbers.

Testing (3 to 6 weeks)

Testing includes unit tests (checking individual functions), integration tests (checking that pieces work together), and user acceptance testing, or UAT, where real stakeholders try the app against real workflows. Automated test suites reduce QA time in later sprints, but only if you build that automation early. Skipping it to “save time” upfront usually costs more time later, when every new feature requires a full manual retest.

Deployment (1 to 2 weeks)

Deployment covers app-store submission, review, and go-live. Apple’s review process typically runs a few days but can extend if your app touches payments, health data, or anything requiring extra compliance checks. Google Play review is usually faster. Build a rollback plan before you submit, not after something breaks in production.

  1. Final build preparation and store listing assets
  2. Submission and review (allow buffer for rejection and resubmission)
  3. Staged or full release with monitoring in place

Post-launch (2 to 4 weeks, then ongoing)

The weeks right after launch need a hotfix window, meaning a team on standby for issues that only show up under real user load. Analytics setup should happen before launch, not after, so you have baseline data from day one. Beyond that window, maintenance becomes a scheduled cadence, not a fire drill, with a backlog for the features you deliberately deferred during MVP prioritization.

What Factors Actually Move Your App Development Timeline

Every schedule change traces back to one of six variables, and knowing which one is at play tells you exactly how many weeks to add.

Scope and feature count. Each meaningful feature typically adds 1 to 3 weeks of development plus proportional testing time. Five extra features rarely means five extra weeks. It often means eight to ten, because features interact and each interaction needs its own test pass.

Integrations. Every third-party API you depend on carries its own lead time and its own maturity risk. A well-documented payment gateway might integrate in days. A legacy accounting system with sparse documentation can eat two to three weeks on its own, entirely outside your team’s control.

Platform choice. Building natively for iOS and Android separately roughly doubles front-end development and testing time compared to a single cross-platform codebase, though native apps often perform better for graphics-heavy or hardware-dependent features.

Hands connecting smartphones for hardware testing

Team model and resourcing. A dedicated full-time team moves faster than one staffed with part-time contributors juggling other projects. Hiring lag alone, the gap between deciding you need a specialist and having them productive, commonly adds 2 to 4 weeks before development even starts.

Regulatory and security requirements. Data residency rules, enterprise single sign-on, or industry-specific compliance needs typically add 2 to 6 weeks, mostly in design and testing, because these requirements have to be verified, not just built.

Approval cycles. Every round of stakeholder review that requires sign-off from multiple people acts as a schedule multiplier. A single decision-maker approving design in two days is very different from five stakeholders needing a week each to review the same deliverable, especially if their feedback conflicts.

None of these factors work in isolation on a real project. A payment integration (factor one) built on a cross-platform codebase (factor two) with a part-time contractor (factor three) compounds delay in ways a simple checklist won’t show you, which is exactly why the businesses building app market volume at scale invest in discovery work before writing a line of code.

Three Sample App Timelines You Can Adapt

Simple app: a single-location booking tool (10 to 12 weeks total)

  1. Discovery and requirements: weeks 1 to 2
  2. Design and prototype sign-off: weeks 3 to 4
  3. Development: weeks 5 to 8
  4. Testing and bug fixes: weeks 9 to 10
  5. App-store submission and launch: weeks 11 to 12

Medium app: a booking-plus-payments platform with CRM sync (20 to 24 weeks total)

  1. Discovery, requirements, and vendor risk assessment: weeks 1 to 3
  2. Design across two sprint reviews: weeks 4 to 7
  3. Development in two-week sprints, front-end and back-end in parallel: weeks 8 to 17
  4. Payment gateway and CRM integration testing (often the tightest bottleneck): weeks 15 to 18
  5. Full QA and UAT: weeks 18 to 21
  6. Deployment with staged rollout: weeks 22 to 24

Complex app: multi-branch queue and staff management system (36 to 44 weeks total)

  1. Discovery across multiple stakeholder groups (ops, IT, finance): weeks 1 to 5
  2. Design with role-based interface variants: weeks 6 to 11
  3. Parallel development workstreams (customer app, staff app, admin portal): weeks 12 to 30
  4. Cross-system integration testing across branches: weeks 28 to 34
  5. Staged rollout, one branch at a time: weeks 35 to 40
  6. Stabilization and full-network go-live: weeks 41 to 44

Pro Tip: If you need to compress any of these, cut scope, don’t compress testing. Removing a lower-priority feature saves real weeks with low risk. Cutting testing time to hit a date is how launches turn into emergency hotfix cycles.

Project Management Tactics That Keep the Schedule on Track

Your finish date is set by the longest chain of dependent tasks, the critical path, not by your total task count. A project with fifty tasks but a short critical path can finish faster than a project with twenty tasks stuck in a long dependency chain. Map your critical path early and update it every time a task slips.

Keep milestones and tasks separate in your plan. A milestone (design sign-off, API integration complete, UAT passed) has zero duration and should trigger a decision or a payment, not consume calendar time on its own. Tasks are the work; milestones are the gates.

  • Report weekly to the delivery team, biweekly to stakeholders who need visibility but not daily detail
  • Flag any critical-path slip within 48 hours, not at the next scheduled check-in
  • Reserve a 10 to 15% schedule buffer for integration and review cycles, since these are where delays cluster most

When a milestone slips, apply a recovery playbook immediately rather than just pushing the end date. Isolate the critical path, pause non-essential feature work, and reassign staff to the tasks actually blocking delivery.

Teams that apply a short recovery playbook the moment a milestone slips recover their schedule roughly twice as often as teams that simply extend the deadline without reallocating resources.

Know when to rebaseline versus renegotiate. If the slip is a one-off (a vendor delay, a sick team member), rebaseline the schedule and move on. If the slip stems from scope that quietly grew past the original plan, that’s a scope conversation, not a scheduling one, and pretending otherwise just guarantees the next milestone slips too.

FlowLab’s Approach to Realistic App Timelines

Most timeline overruns trace back to one root cause: unclear requirements discovered mid-build instead of before it. Flowlab runs discovery first, mapping your actual operational workflow before recommending anything, which is why projects that start with a clear feature list and MVP definition tend to avoid the rework that eats weeks later in development.

Not every project needs a custom build. When your workflow closely matches an existing pattern, queue management, point-of-sale, event registration, lead tracking, Flowlab recommends adapting a ready-made product foundation instead. That path typically shortens the calendar significantly compared to building every screen and integration from zero, because the core architecture and integrations already exist and only need configuration for your workflow.

Flowlab’s complimentary app fit review produces three things before you commit to anything:

  • A rough calendar estimate based on your actual workflow, not a generic template
  • A cost band so you know what range you’re planning against
  • A recommended approach: ready-made product, adapted solution, or custom build

To get the most out of the review, come with a plain-language description of your current process and where it breaks down. No technical brief required.

Why Most Timeline Advice Skips the Real Question

Most timeline guides answer “how long does an app take” as if every project starts from zero. That’s the gap in the conventional advice: the biggest schedule lever isn’t sprint velocity or team size, it’s whether you’re building from scratch at all. A workflow that matches an existing product pattern, a queue system, a booking flow, a lead tracker, can often skip months of the build entirely, and no amount of agile process discipline substitutes for that decision made correctly at the start.

Where I think most SME owners get it wrong is treating discovery as a formality to rush through so “real work” can start sooner. The data doesn’t support that instinct. A rushed discovery phase is exactly what produces the mid-development scope changes that blow up a 5-month plan into an 8-month one. The two or three weeks spent nailing down a prioritized feature list is the cheapest insurance you’ll buy on the entire project.

Prioritize getting your workflow assessed honestly before you prioritize a launch date. The date should follow from the assessment, not the other way around.

— Ronald

Get a Realistic Timeline for Your Own App

Flowlab gives you a straight answer to “how long will this actually take” before you spend a dollar, not after. Where a typical agency quotes a custom build by default, Flowlab starts by checking whether your workflow already matches an existing product foundation, which is often the difference between a 3-month timeline and a 7-month one.

Flowlab

If your business runs on customer queues, Flowlab’s queue platform is worth seeing in action first. You can try the complete queue journey yourself to see how much of that “custom build” your team assumed you needed is actually already solved. For pricing and inventory workflows, the right product answer, ready when your staff need it, works the same way: configuration instead of construction.

Every engagement starts with a complimentary app fit review, no commitment, no technical brief required. Bring a plain description of how your team currently handles the process you want to fix, and request your app fit review with Flowlab to get a rough timeline and cost band back before deciding anything.

Sources

The phase ranges and recovery tactics in this guide draw from a handful of practitioner sources worth bookmarking if you’re building your own schedule.
